News Roundup: Baldy

Vail Resorts Plans Lift Upgrades at Hunter Mountain and Blackcomb in 2024

Vail Resorts today announced its initial 2024 capital plan, which includes three new lifts. The largest project will be at Hunter Mountain, where Vail intends to replace the Broadway quad with a six seat detachable. The top terminal will be relocated near the bottom of Lower 42nd Street to improve access to Eisenhower and Gun Hill. Existing Broadway Limited equipment will be moved to replace Lift E, a Hall double dating back to 1968. E’s alignment will move east to the middle of the learning area. Vail says these new lifts will provide “a meaningful increase in uphill capacity and improved access to terrain that is key to the progressive learning experience for our guests.”

At Whistler Blackcomb, Vail will build its fourth new detachable in three years. The new Jersey Cream Six will utilize parts originally intended for Eagle Express at Park City before local approval was revoked in 2022. Vail then sought to replace the Jersey Cream quad in 2023 alongside the Fitzsimmons 8 project, but labor shortages only allowed one project to be finished this fall. Doppelmayr Canada did complete 11 of 15 tower bases for Jersey Cream over the summer and the UNI-G six pack will now open for the 2024-25 ski season.

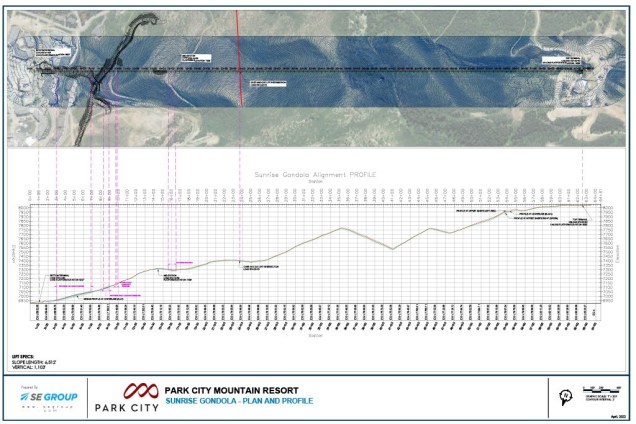

Finally Vail announced its intention to complete the new Sunrise Gondola at Park City’s Canyons Village in 2025. The 10 passenger gondola will run from near the new Pendry Hotel to Red Pine Lodge. The third out-of-base lift will be funded in part by the Canyons Village Management Association.

The company reported season pass sales increased approximately 7 percent in units and 11 percent in sales dollars in dollars compared to the equivalent period last year. Vail Resorts also reported a decrease in net income from $347.9 million for fiscal year 2022 to $268.1 million for fiscal 2023. The decrease was primarily attributed to “a large gain on disposal of fixed assets in fiscal 2022 and an increase in fiscal 2023 expense associated with a change in the estimated fair value of the contingent consideration liability related to our Park City resort lease.” Vail also said higher employee wages, a poor winter in Australia and lower demand for summer mountain travel negatively impacted results.

Snowbird to Replace Wilbere Lift

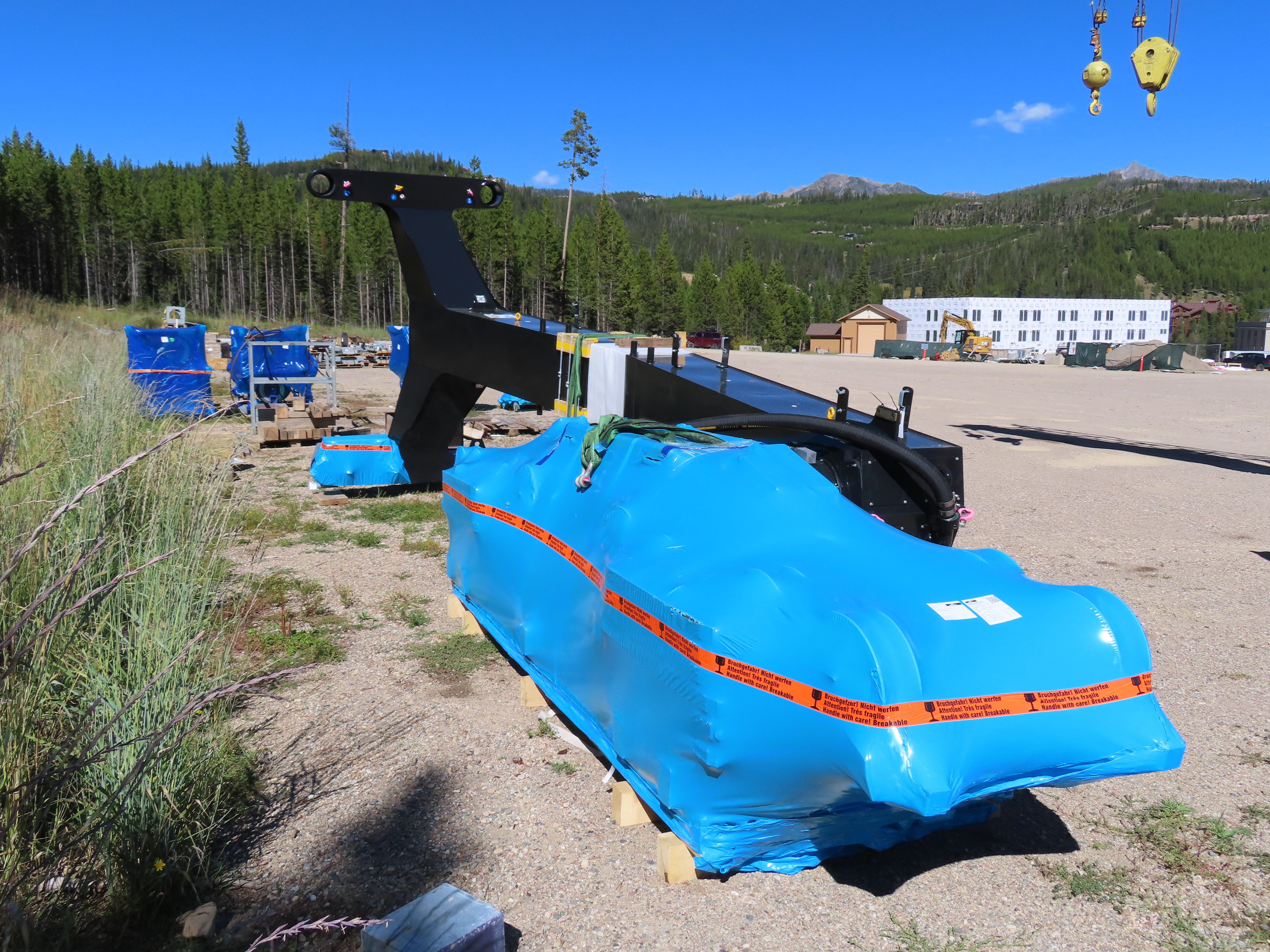

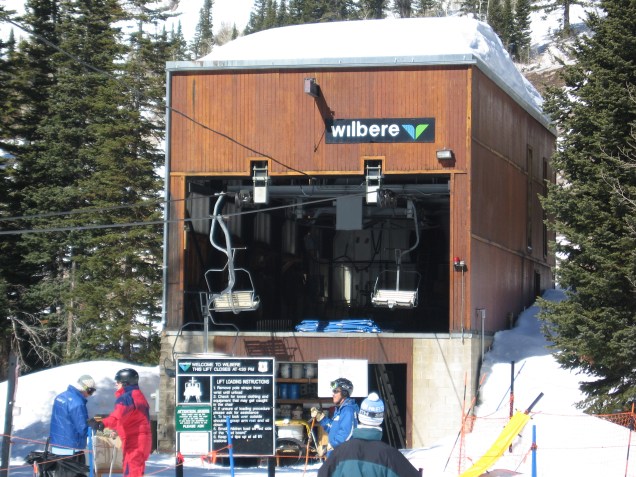

Doppelmayr has been selected to install a new Wilbere Quad next summer at Snowbird, the second new lift announced by Powdr for 2024. The quad will load in a new location in the Creekside base area and terminate near the top of the current Wilbere double, which Doppelmayr built in 1971. The modern AlpenStar fixed grip will feature a loading conveyor and carry 1,800 skiers per hour.

“With a number of short- and long-term projects in the works, we are taking great strides to make our mountain more accessible, more efficient and more engaging for our passholders and our community,” noted Snowbird President and General Manager Dave Fields. Wilbere 2.0 is expected to open for the 2024-25 ski season.

North America Fuels Growth for Doppelmayr

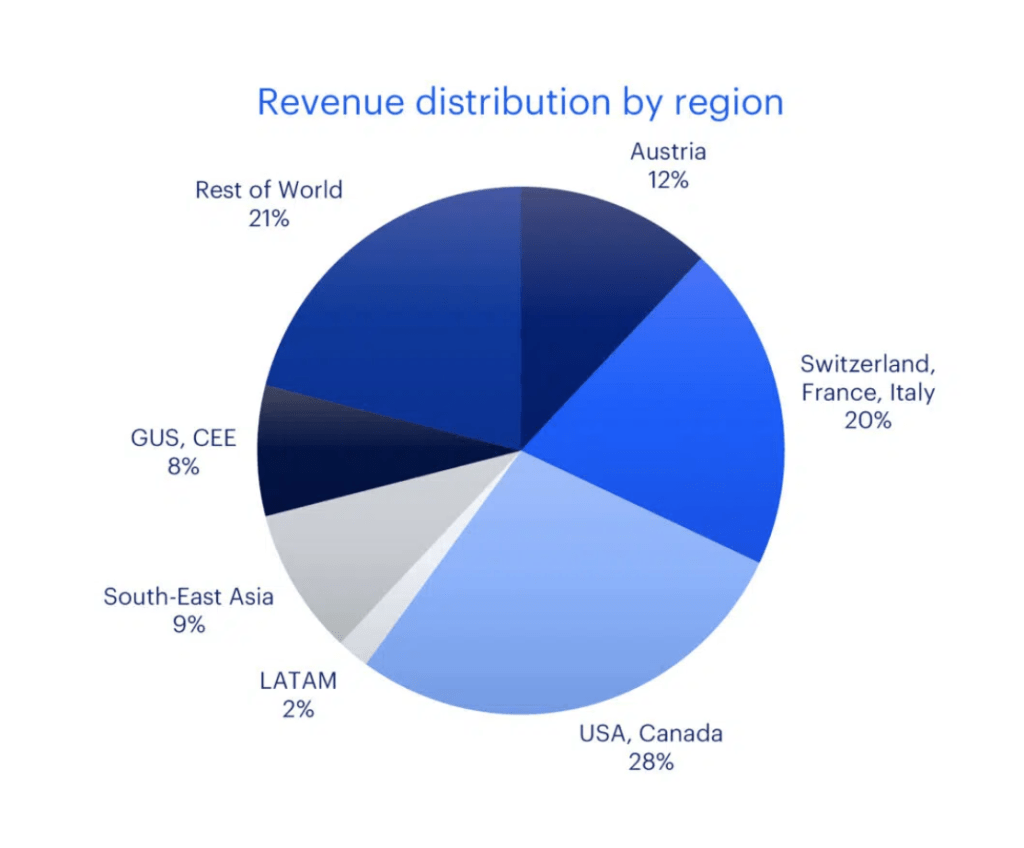

The Doppelmayr Group reported annual financial results today, and for the first time ever, North America surpassed Austria as the firm’s largest market. Doppelmayr reported total revenue of €946 million (US$1.0 billion) in fiscal year 2022-23, an annual increase of 6.7 percent and near a record high for the 130 year old company. The United States and Canada accounted for 28 percent or approximately $280 million during the fiscal year, which ran from April 2022 through March 2023. The last year before Covid North America represented only 17 percent of global turnover while the domestic Austrian market comprised 24 percent of the business.

The group delivered 104 ropeways globally in 2022-23, 30 of which landed in North America. US ski resorts reported a record 64.7 million skier visits last season and have 31 more Doppelmayr lifts under construction for the coming winter. “One of the reasons for this market development is the continuing attractiveness of outdoor sports,” noted the Doppelmayr Group annual report. “Many ski resorts are replacing outdated installations with modern ropeways in order to offer their guests enhanced comfort. In addition, the new lifts feature higher capacity to provide the growing numbers of visitors with rapid access to the ski slopes.” Doppelmayr went from installing just one D-Line detachable in North America in 2018 to five last year and nine this year. Doppelmayr also increased its global employee headcount to 3,335 full time equivalents, an increase of 5.7 percent. Part of that growth was the group’s acquisition of cabin manufacturer Carvatech last October.

Doppelmayr also reported a strong order book despite some economic headwinds. “The investment strength of ski area operators in North America remains at a very high level,” the company noted. The Alps market is also strengthening with three AURO autonomous gondolas under construction. On the urban front, Doppelmayr is working to build expansive gondola systems in both Paris and Mexico City. Doppelmayr also expects revenue growth from new products, including its clair software platform, upcoming TRI-Line 3S system and new 20-MGD D-Line.

News Roundup: First Day of Fall

Monarch Mountain Looks to Expand

Independent Monarch Mountain would expand lift service to No Name Basin in a plan under review by the Forest Service. No Name sits over the Continental Divide from the existing Breezeway terrain pod and is currently skied via snow cat. If approved, the first new lift at Monarch since 1999 would be a fixed grip triple or quad rising 960 vertical feet. It would be approximately 2,700 feet long and carry 1,800 skiers per hour to an elevation of 11,700 feet.

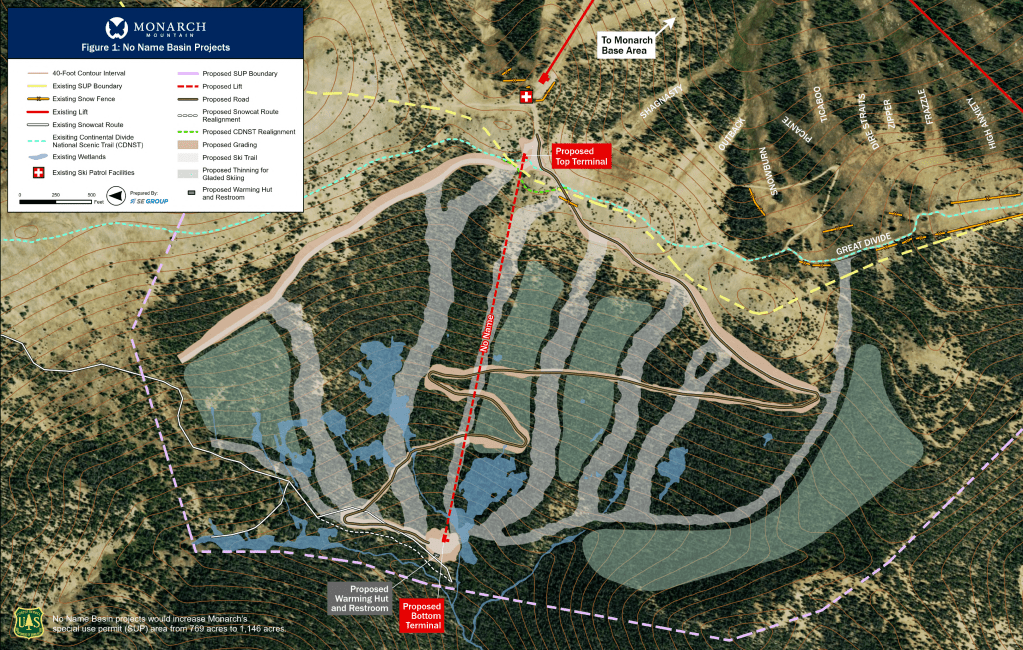

Monarch plans to clear 62 acres of developed trails and glade additional acreage within the proposed 377 acre expansion zone. A new service road, warming hut and restroom are also planned. “The development of No Name Basin for downhill skiing would improve the recreation experience for guests of Monarch by offering more lift-served terrain that caters to intermediate and advanced ability level skiers,” the ski area notes. “In addition, Monarch hopes to meet evolving guest demand for more varied and interesting terrain.” The expansion lies in a different National Forest than the rest of Monarch so the Pike-San Isabel National Forest and the Grand Mesa, Uncompahgre and Gunnison National Forest are both seeking public comments on the project here. An Environmental Assessment is expected to be completed in April 2024.

Three New Lifts Coming to Lake Louise

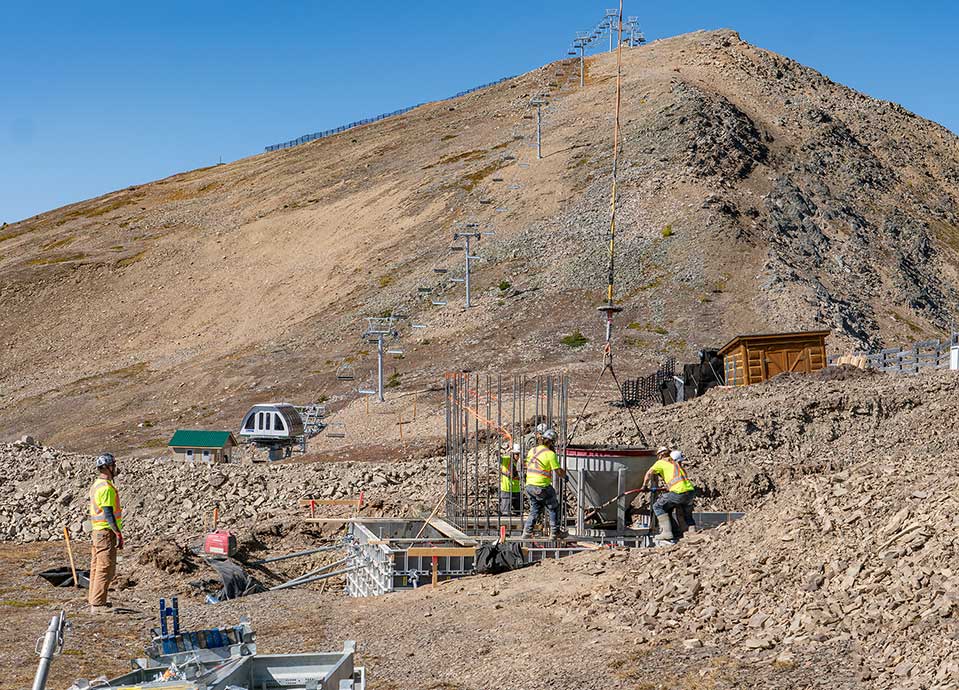

One week after Sunshine Village announced a new bubble chair with heated seats, Lake Louise says it will build one too. Foundation work is already underway for the Upper Juniper detachable quad, which will connect the top of the two year old Juniper Express with the Top of the World. Upper Juniper Express will be constructed by Doppelmayr Canada and open for the 2024-25 ski season. “This new lift should not only enhance accessibility to the upper mountain, but substantially alleviate base area congestion even during peak days,” said Lake Louise.

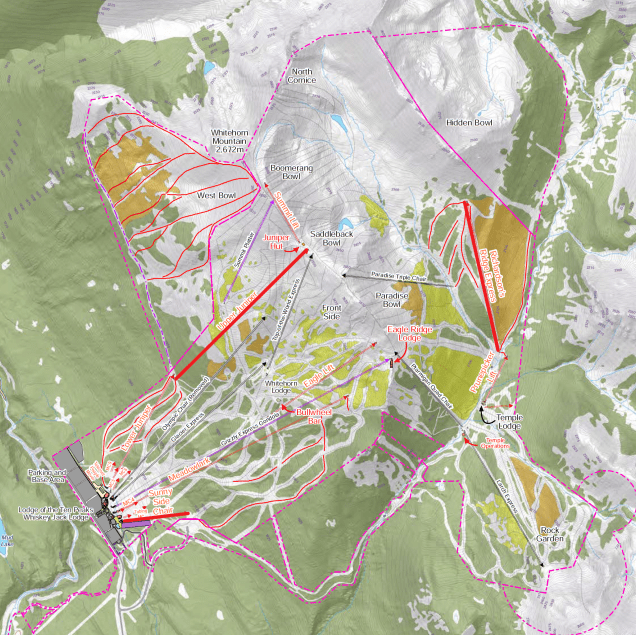

Two additional chairlifts will debut for the 2025-26 season, one a beginner lift called Sunny Side and the other an expansion behind Paradise Bowl. Richardson’s Ridge Express will service a “vast expanse of intermediate and advanced terrain,” said the ski area. Construction of the second new high speed quad will take two years with foundations installed in 2024 and steel following in 2025. The Sunny Side beginner chairlift will also be constructed in the summer of ’25. “This new chair will provide comfortable and quick access to our superb beginner terrain,” noted Lake Louise.

Big Sky Readies America’s Next Great Tram

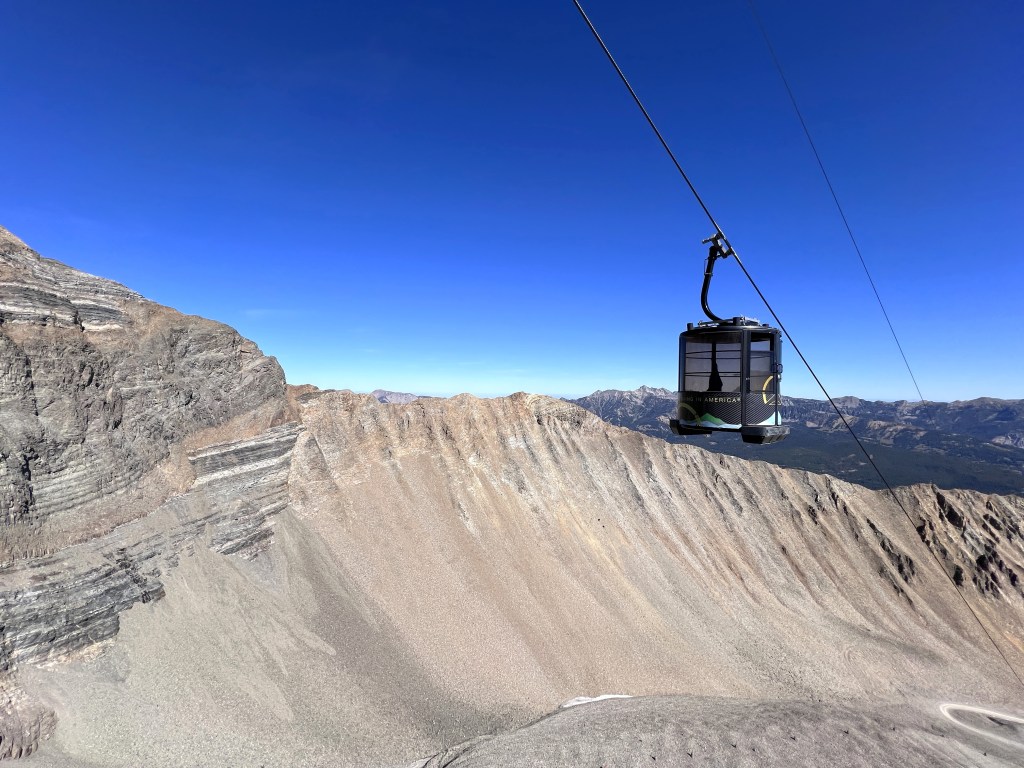

Garaventa and Big Sky Resort are in the home stretch of a herculean effort to bring modern lift service to Lone Peak, the first new tram built at a North American ski area since 2008. Switzerland-based Garaventa is the same outfit that brought skiers the new Jackson Hole tram 15 years ago, the Snowbird tram in 1971 and the Palisades Tahoe tram before that.

The original Lone Peak Tram, which catapulted Big Sky to the upper echelon of extreme skiing in 1995, will carry its final souls a few weeks from now. The only passengers left to hoist are construction workers and a few lucky spectators touring the progress. With one rope and 15 passenger “beer can” cabins, the tram is more jig-back gondola than a true aerial tram. It was built by Doppelmayr, the Austrian heavyweight which absorbed Garaventa six years after skiers began conquering Lone Peak. Garaventa remains a specialized subsidiary of the Doppelmayr Group focused on aerial trams, funiculars and the Swiss market.

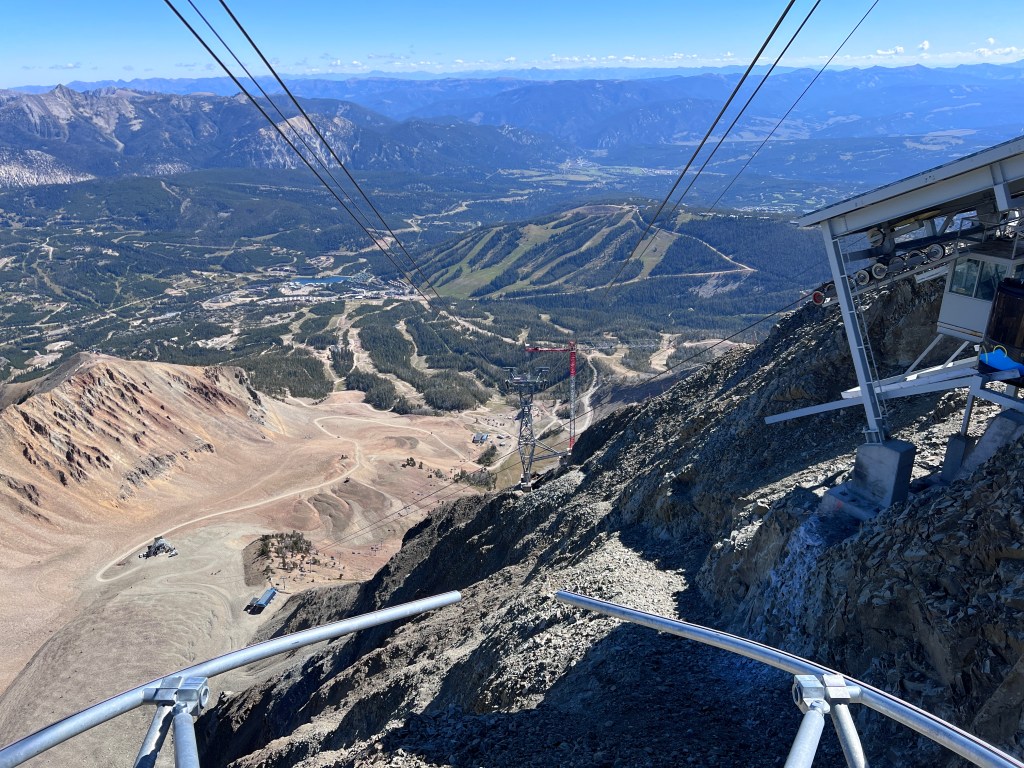

The old tram needed to go. The bottom terminal was built atop a rock glacier and, while designed for it, flowed at least 25 feet downhill over the past 28 years. The lower dock no longer sits level such that water pools in triangles at corners. Erroneous faults occur routinely as the tram completes its final missions to 11,166 feet (it’s not a safety issue, each fault is investigated before the lift is restarted).

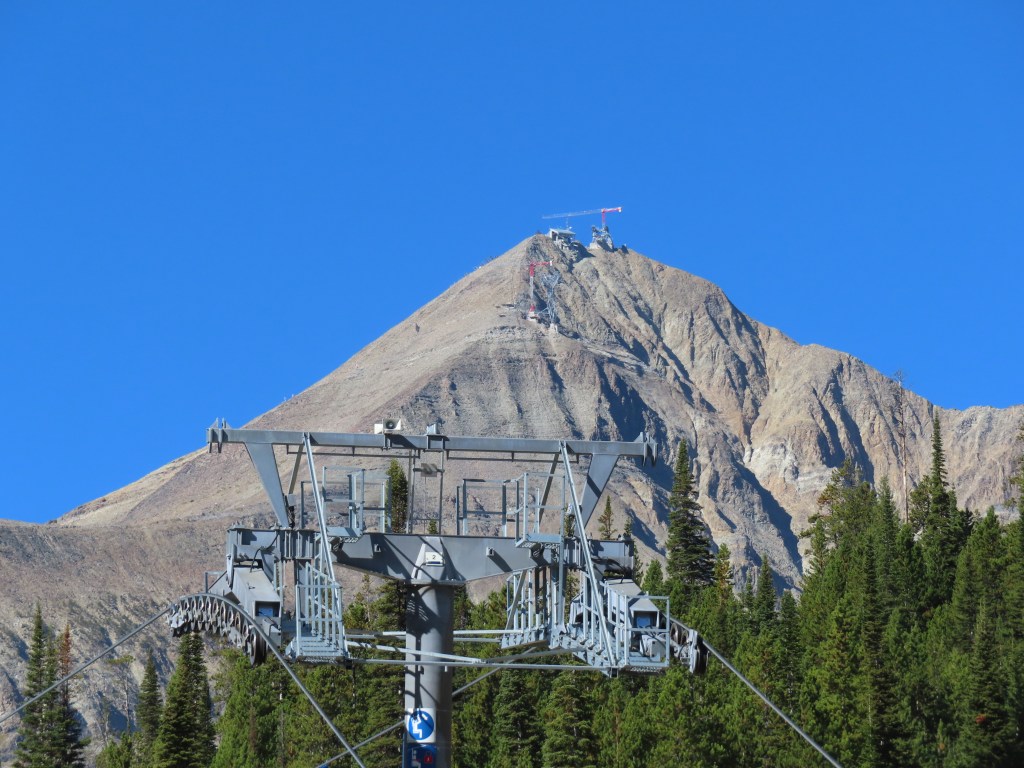

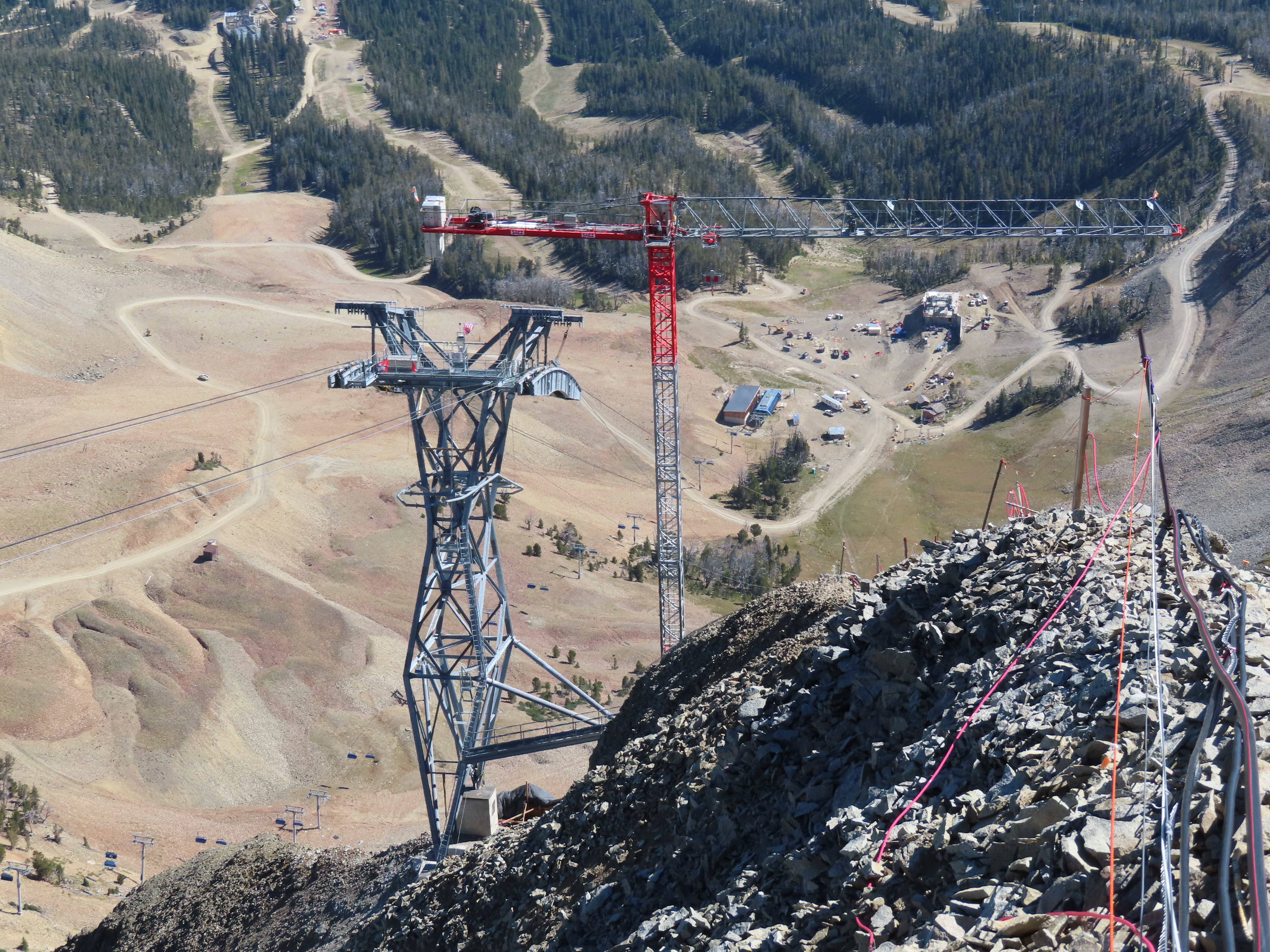

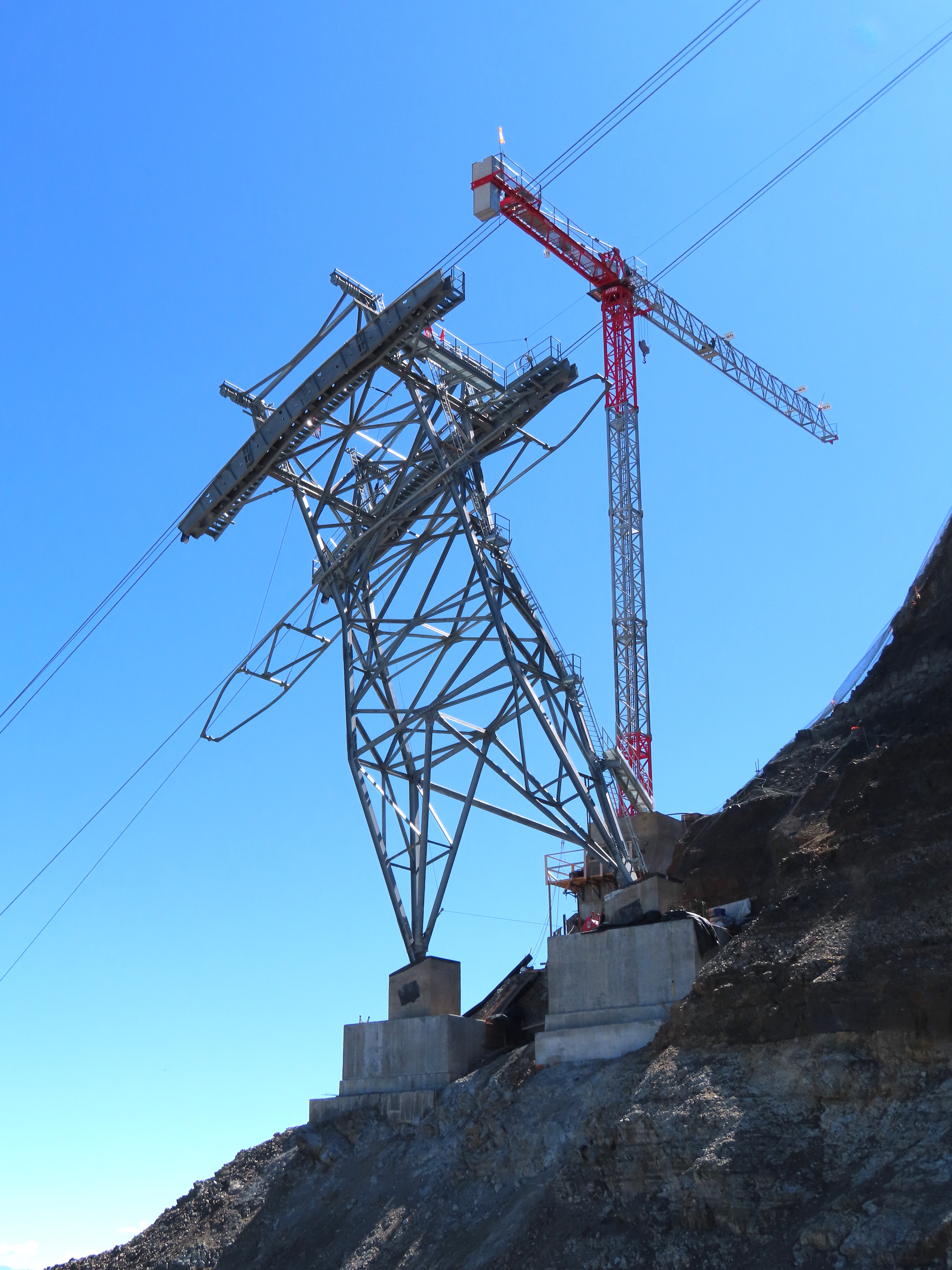

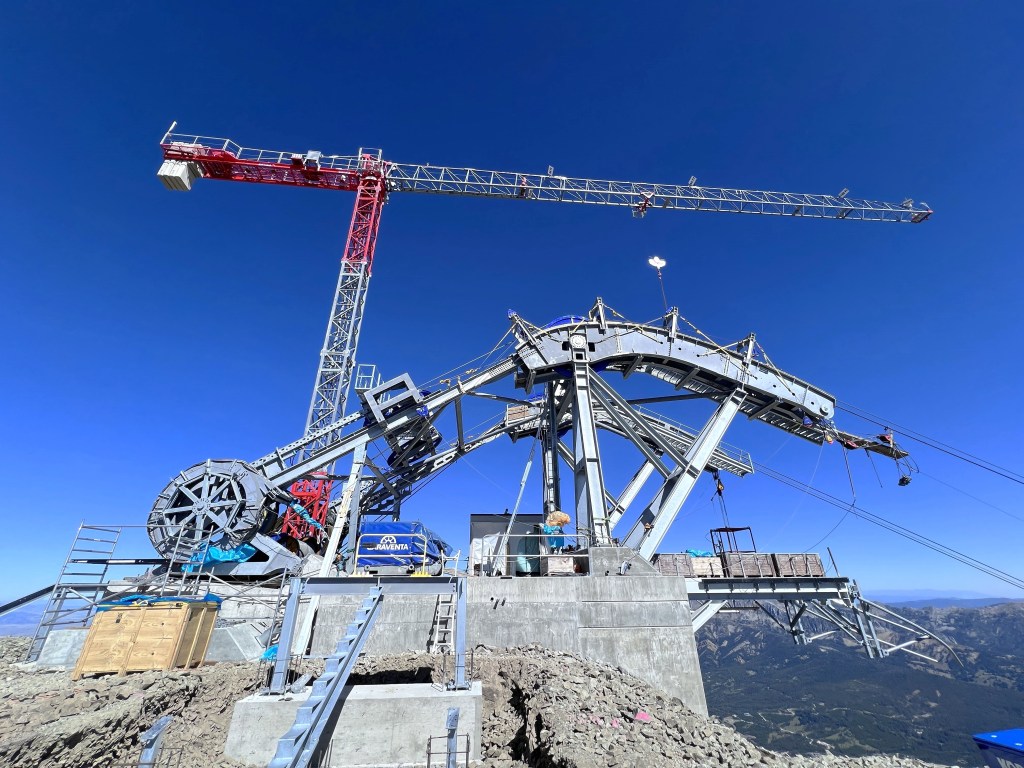

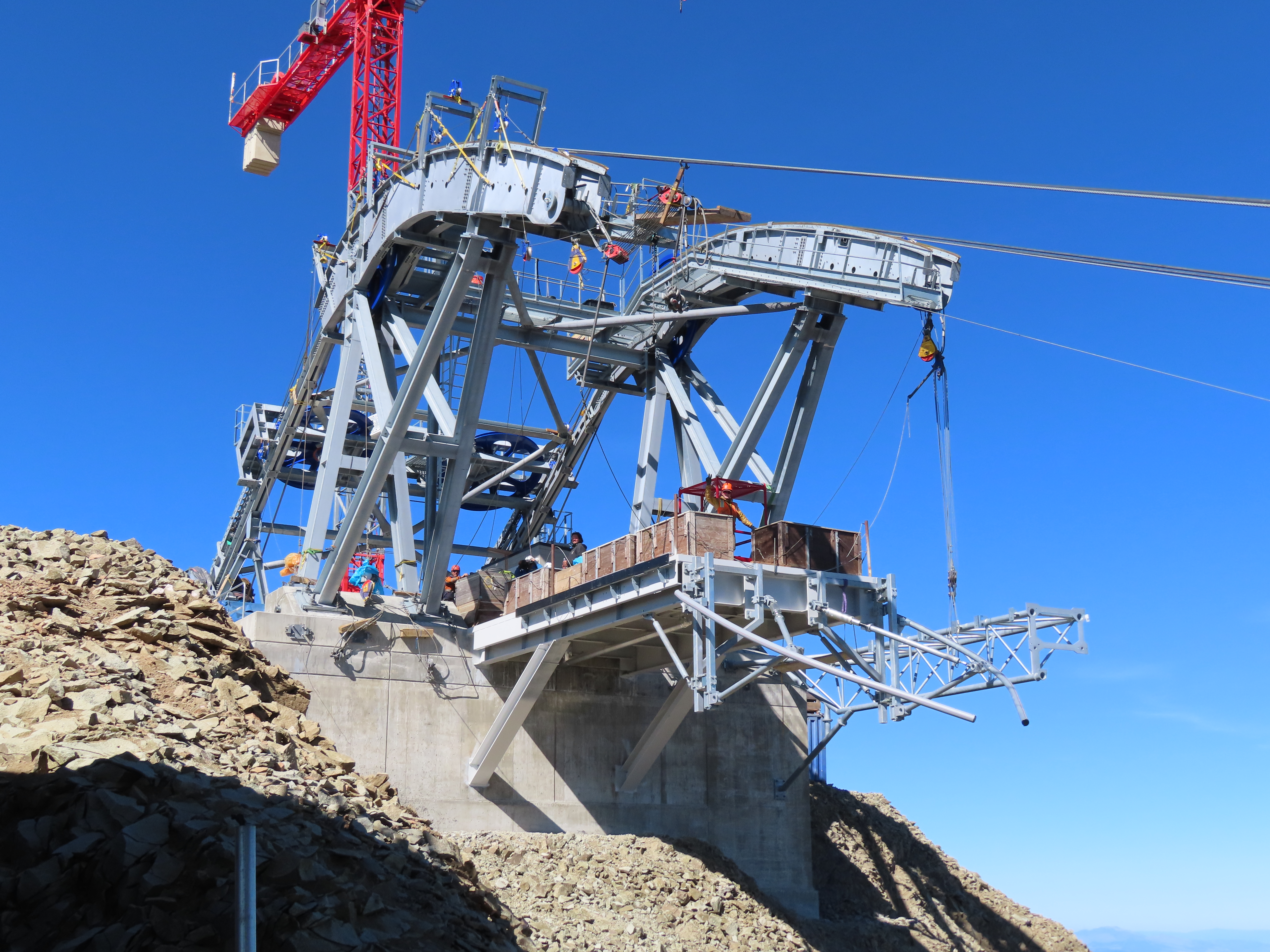

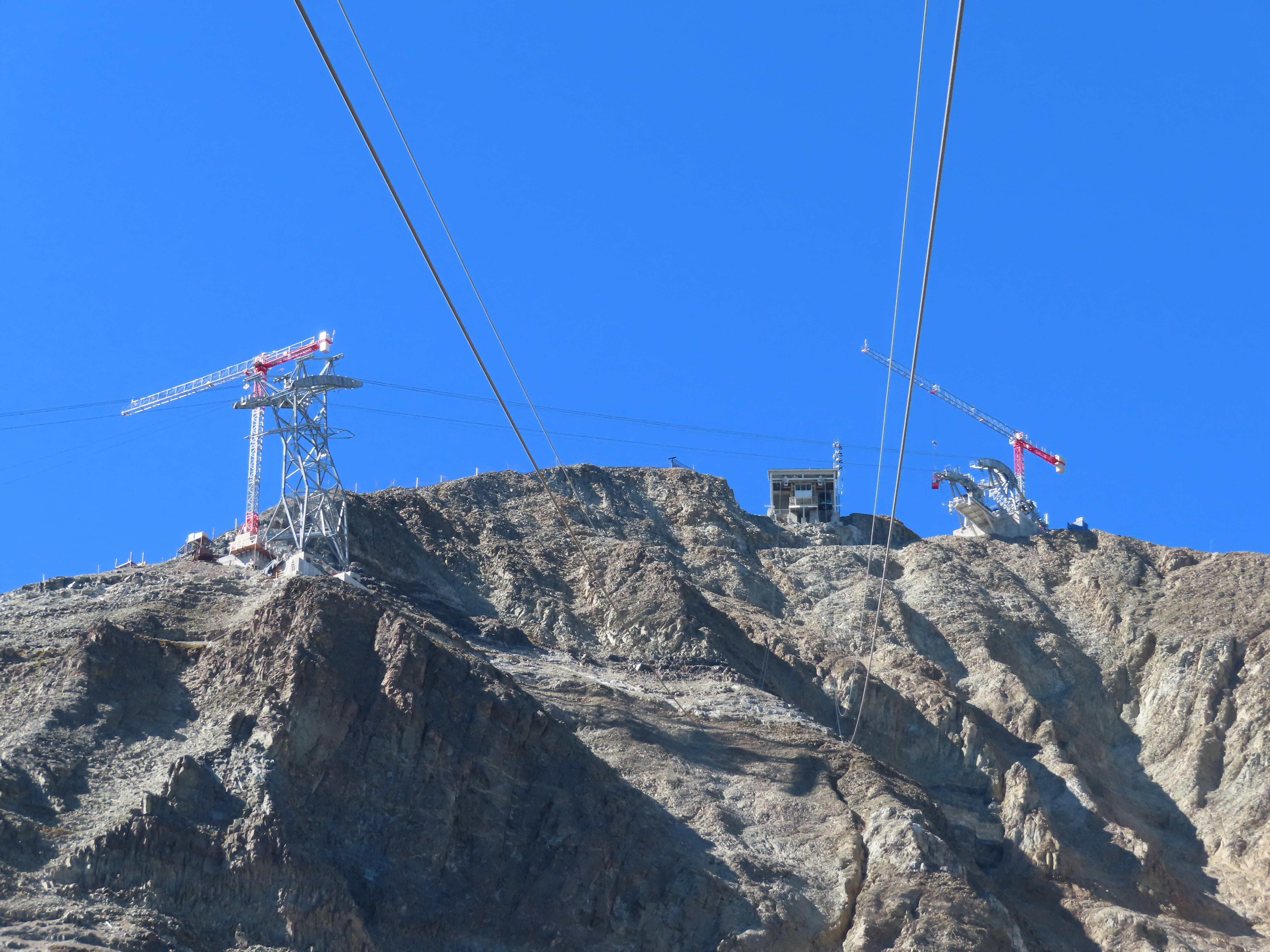

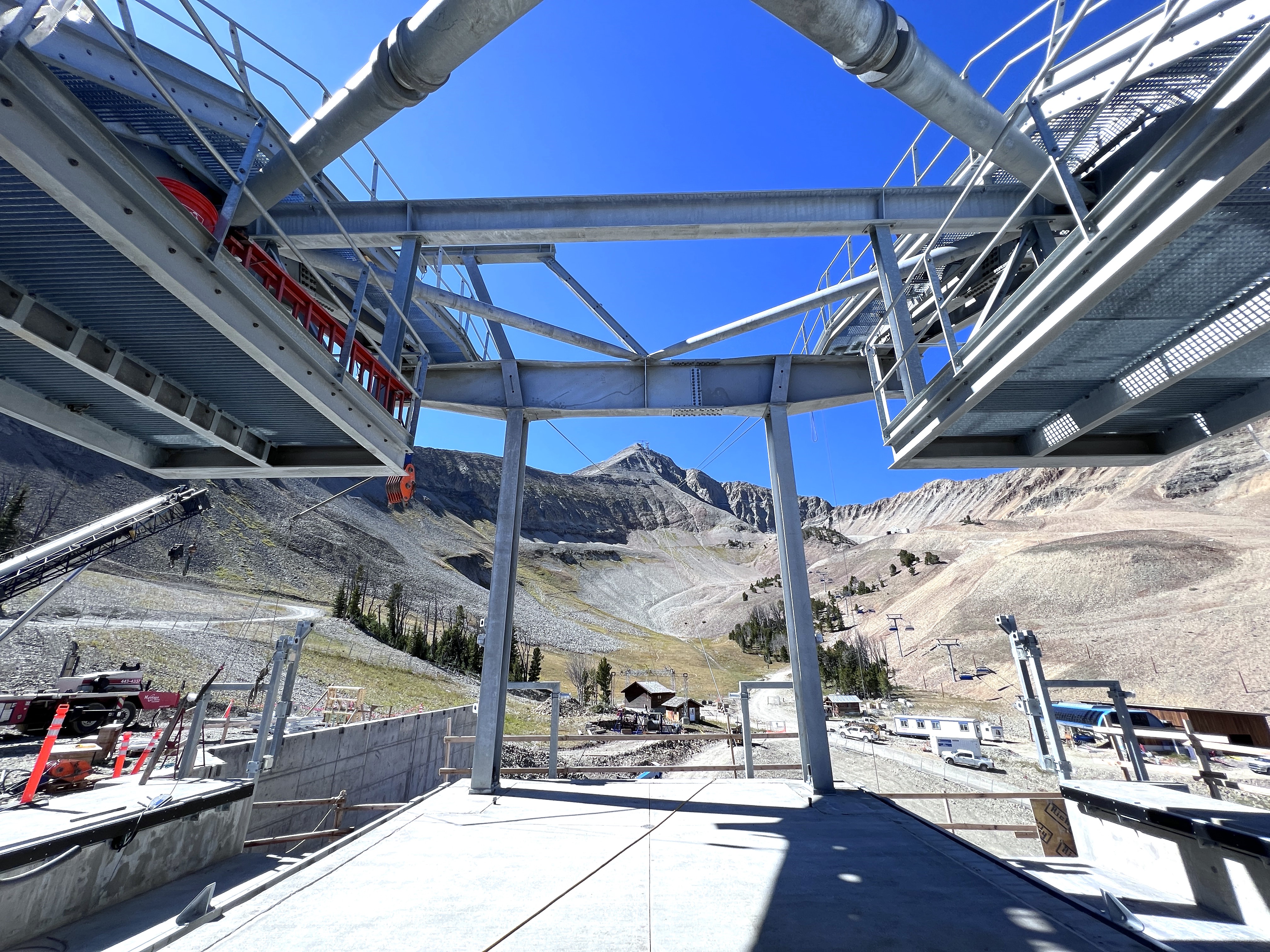

This summer’s greatest challenge was not the tram installation itself but rather setting twin tower cranes needed to build the 100 foot intermediate tower and top terminal. Each crane had to be flown in sections weighing up to 9,000 lbs. It took multiple Chinook helicopters weeks with pauses for bad weather and other setbacks. Once the cranes were live and Big Sky’s own employees trained to operate them, the installation team from Garaventa could get to work.

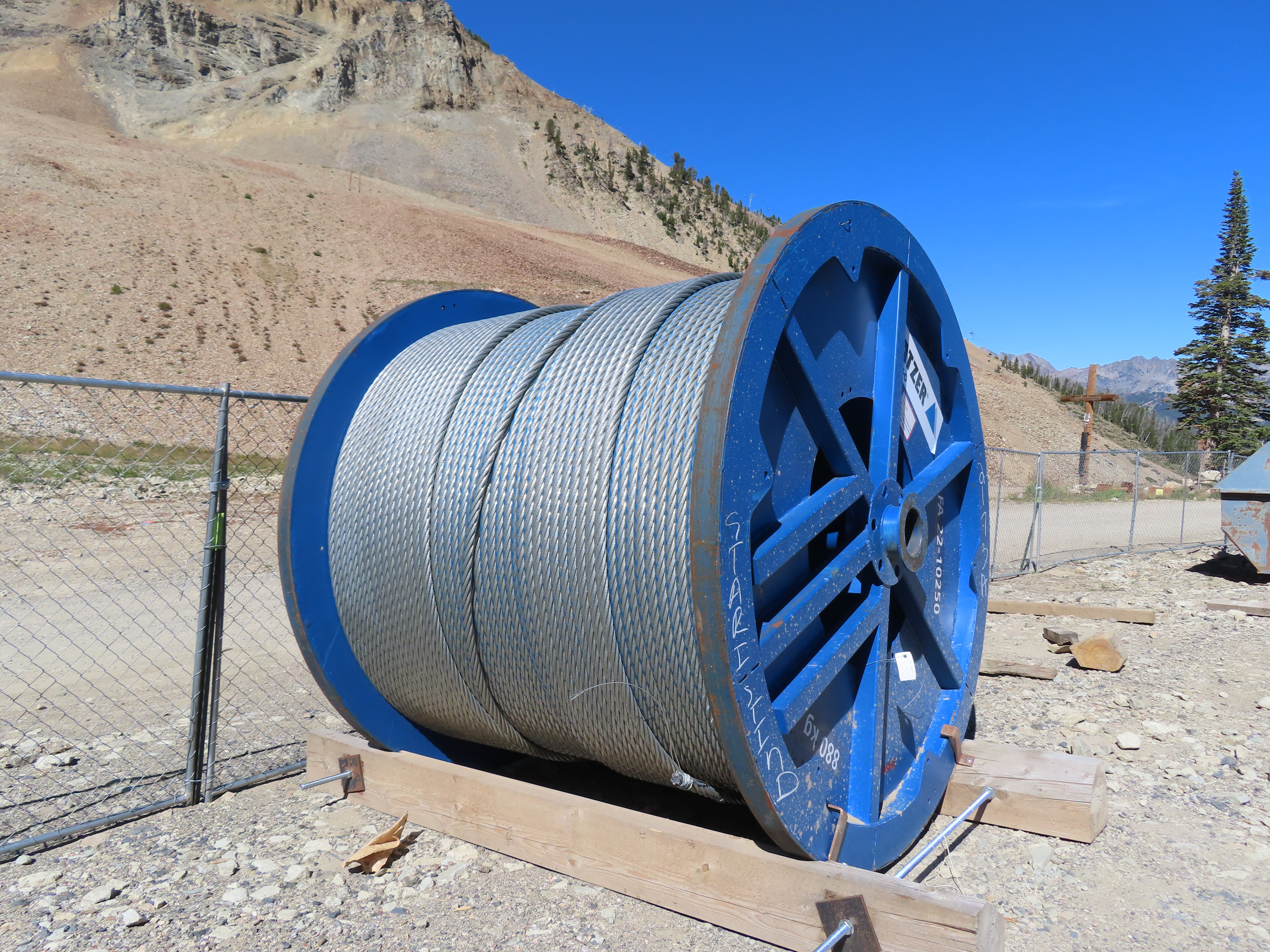

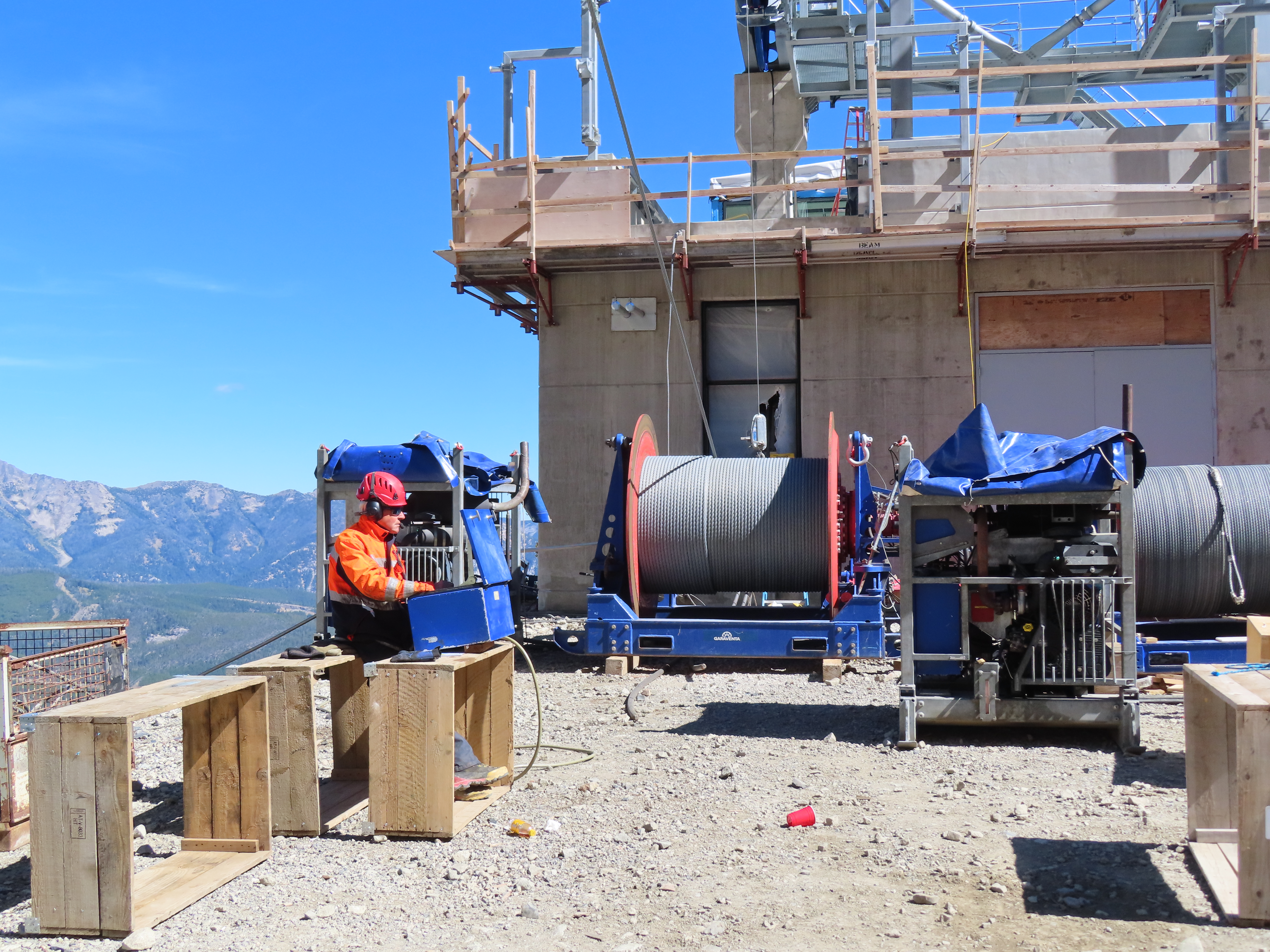

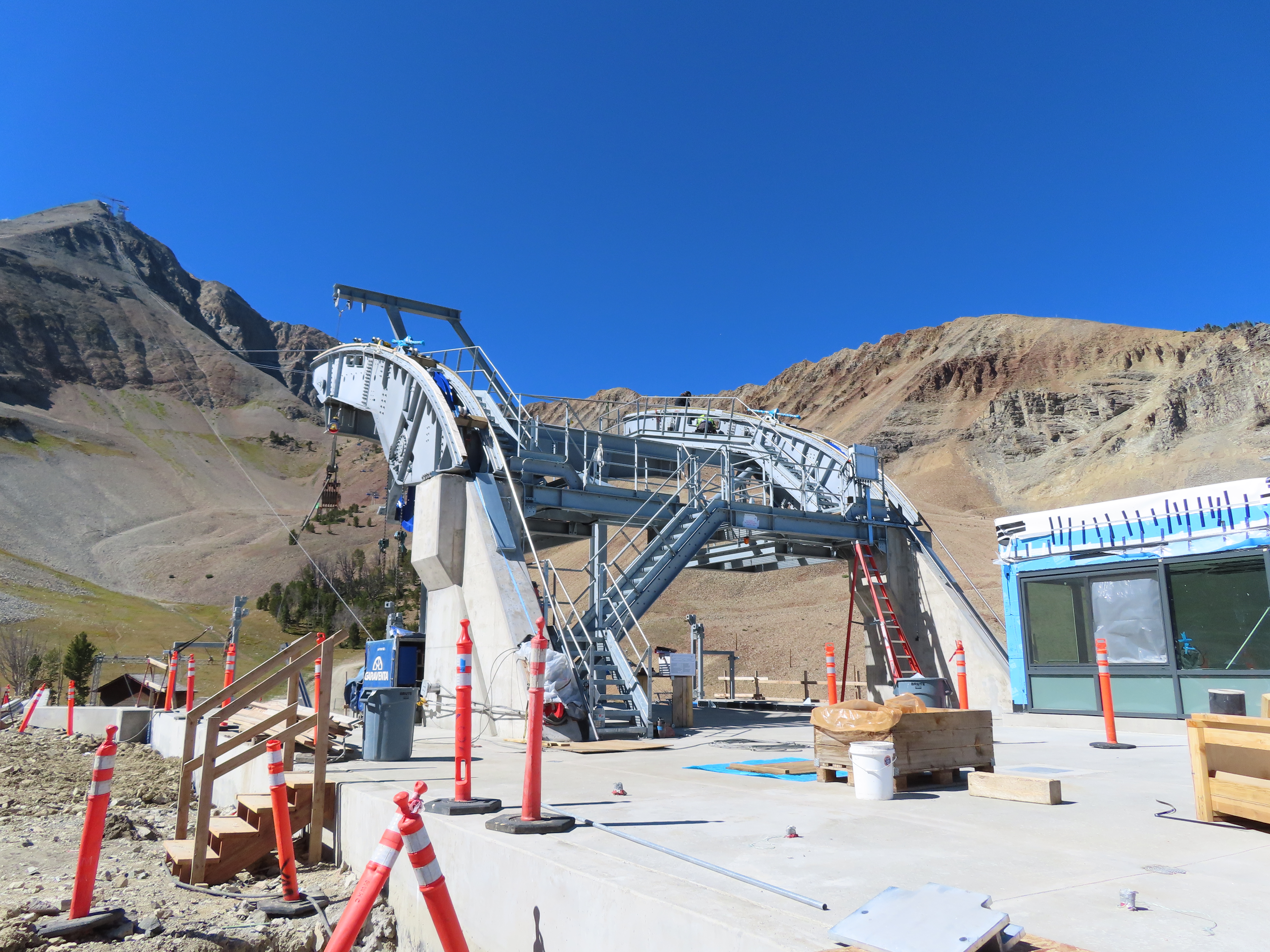

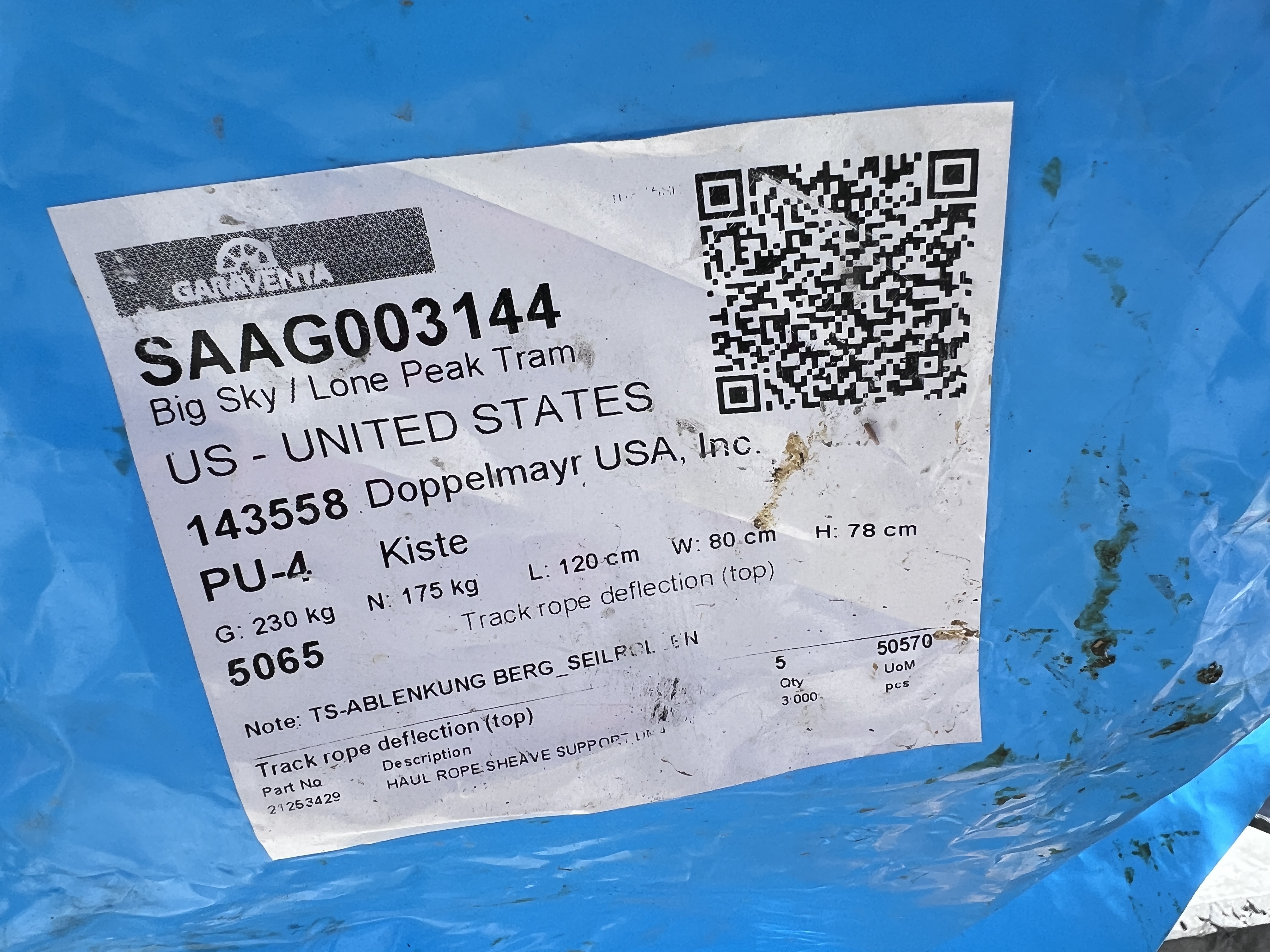

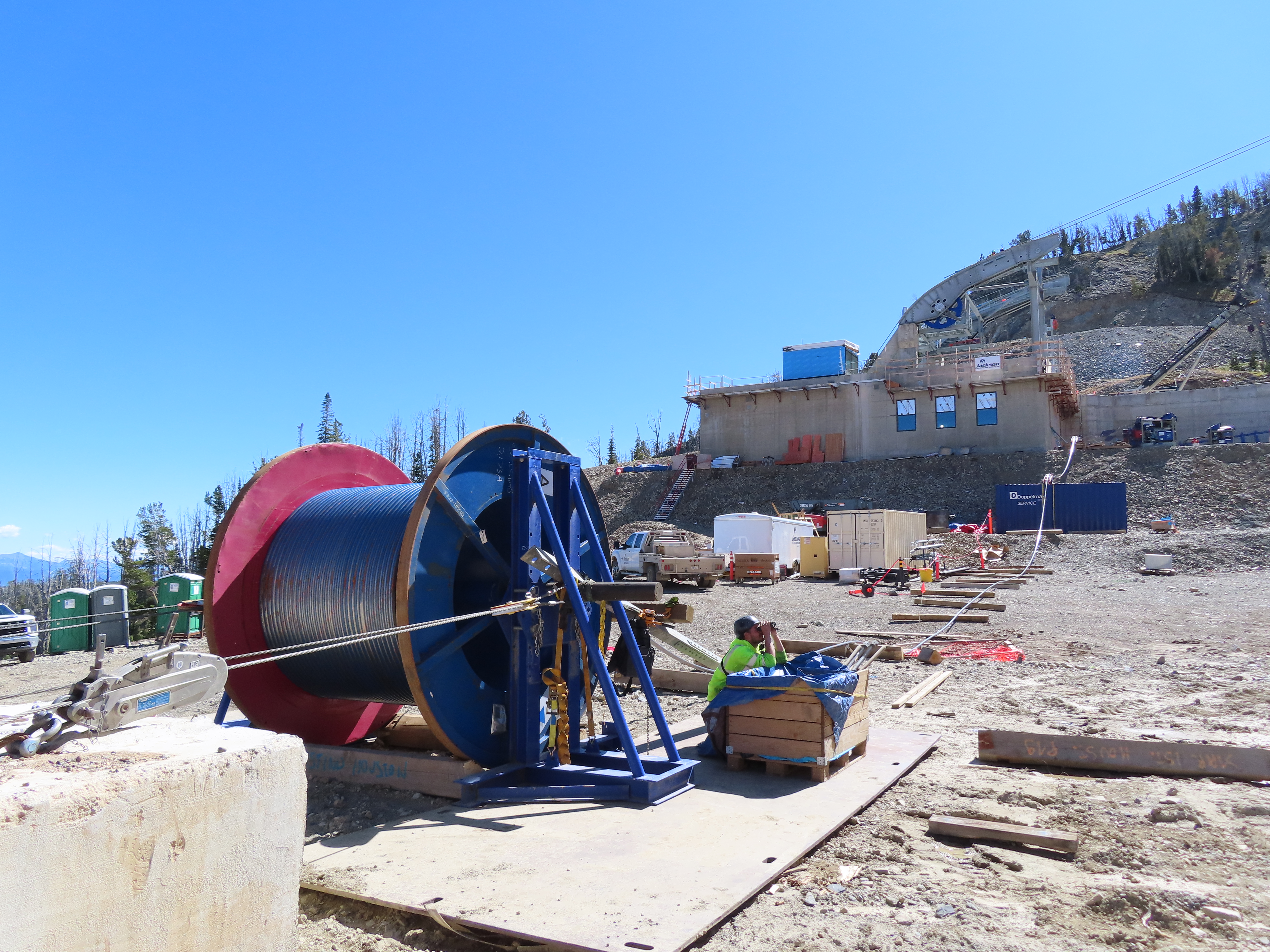

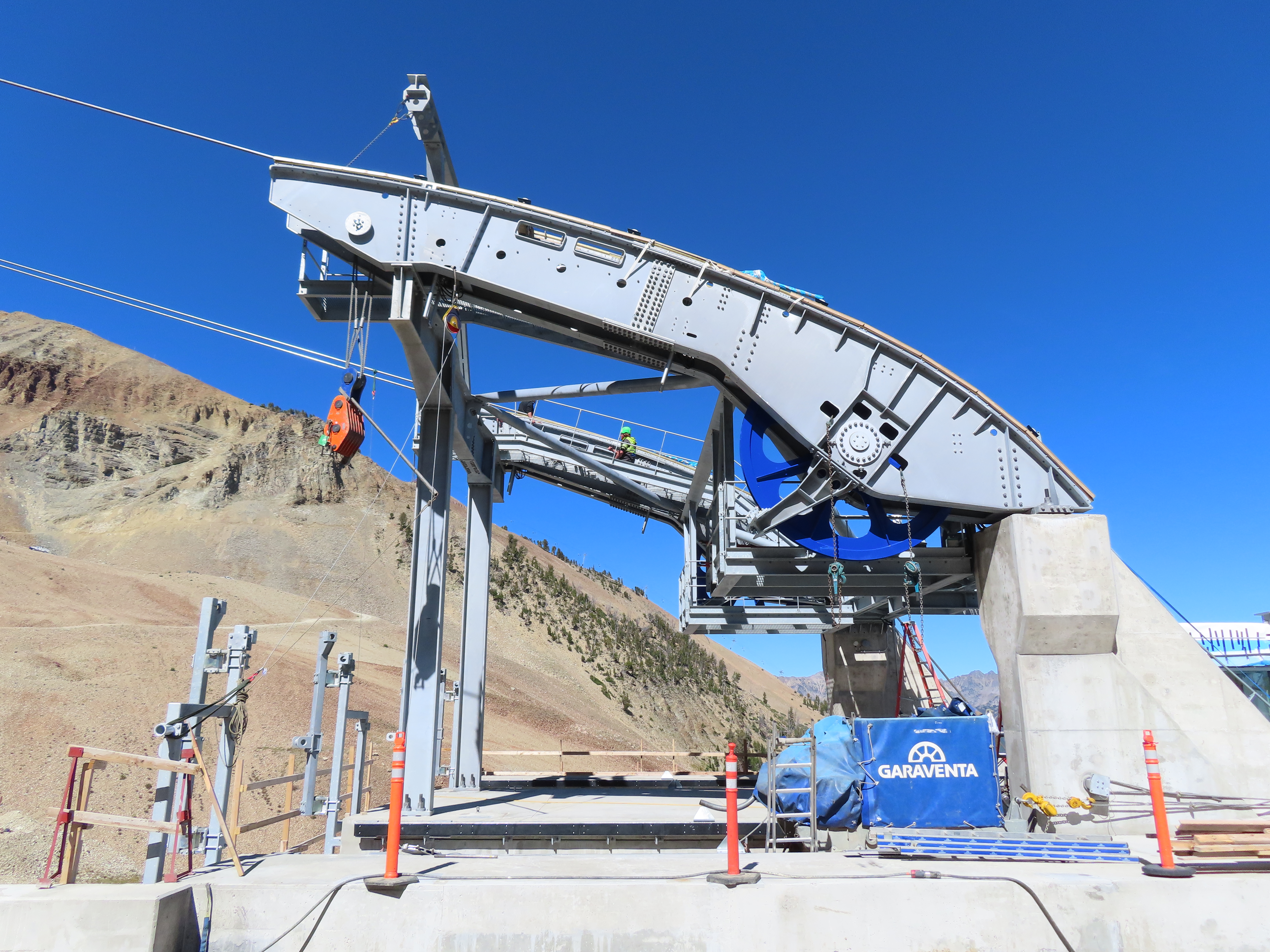

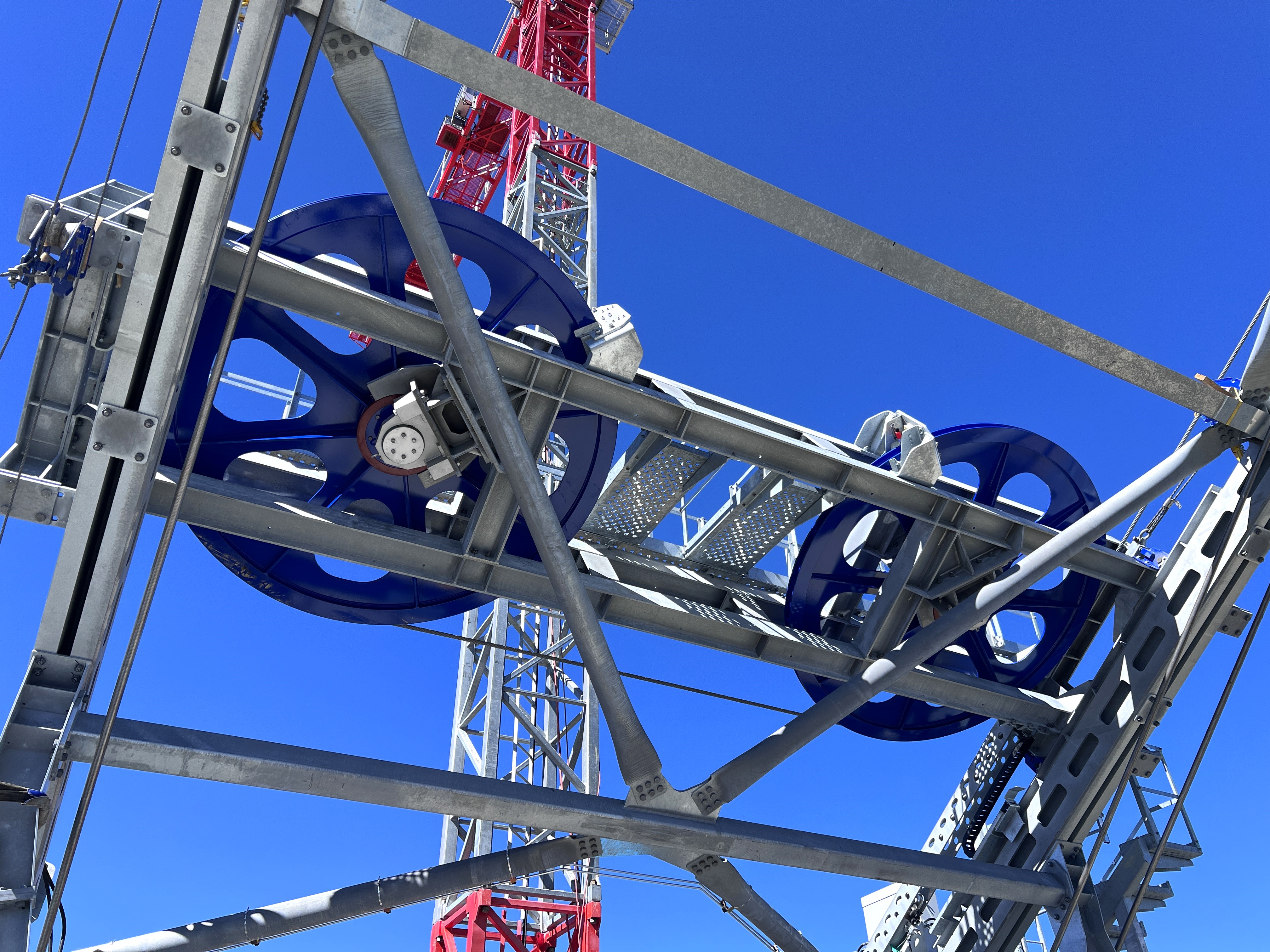

Big Sky and contractors completed micropiles, tiebacks and concrete work last summer, setting the stage for this summer’s steel erection and rope pulling marathon. As of today, three of the four track ropes are on their bollards. A fourth track rope pull is in progress with the haul rope on deck. For each track rope, a helicopter pulled a 10 mm pilot line up to the top terminal and back down. Then crews attached and pulled successively larger 18 mm, 22 mm and 32 mm ropes until finally the smooth 48 mm track rope was up the line. The process is slow and steady with up to 10 Swiss men on headsets and binoculars monitoring every inch of progress for 5-6 days per rope. The 37 mm haul rope will be pulled in similar fashion and spliced into a continuous loop like more traditional ski lifts. The tram will be driven from the bottom station with no counterweight required for tensioning. Redundancy is built in everywhere, from multiple transformers to dual motors, evacuation drives and generators. Frey AG Stans supplied the lift’s state-of-the-art control system, similar to one recently installed on Snowbird’s tram.

This winter, guests will pay per tram ride rather than a daily rate as they did in the final years of the old tram. Big Sky notes the average tram day pass purchaser only rode 1.8 times. The privilege cost $20 to $100 depending on demand and some were riding the tram multiple times solely to feel better about their investment. This added to long lines and detracted from the Lone Peak experience. New tram access will cost less – $10 to $40 per ride – charged automatically to a credit card with each scan at the bottom dock.

Big Sky Ski Patrol will monitor conditions hourly and decide how many skiers and snowboarders to let on the cars, which can hold up to 75 riders. Big Sky will also debut a sightseeing specific line designed to fill excess tram capacity with guests not utilizing limited ski terrain off the summit. Come 2025, foot passengers will be able to ride a new 10 passenger gondola from the Mountain Village right to the base of the new tram. This boarding location lies 700 vertical feet lower than the old tram station, eliminating the need to ride Powder Seeker for a tram lap. Most importantly, it’s below the rock glacier. The new tram will eventually open year round, though summer 2024 will be spent completing glass enclosures around each station.

Once rope pulling wraps up, the tram’s two cabins will be driven up from the village and attached to the haul rope. The CWA cabins will feature automatic doors, a glass floor panel and seating for 12. Acceptance testing is expected to take four to five weeks. Big Sky has been careful not to advertise a grand opening date, but the word December is being thrown around. That month will mark 15 years since the last new tram debuted in this part of the world and 50 years since Big Sky opened.
