Steelhead Systems Responds to Ski Bluewood Lawsuit

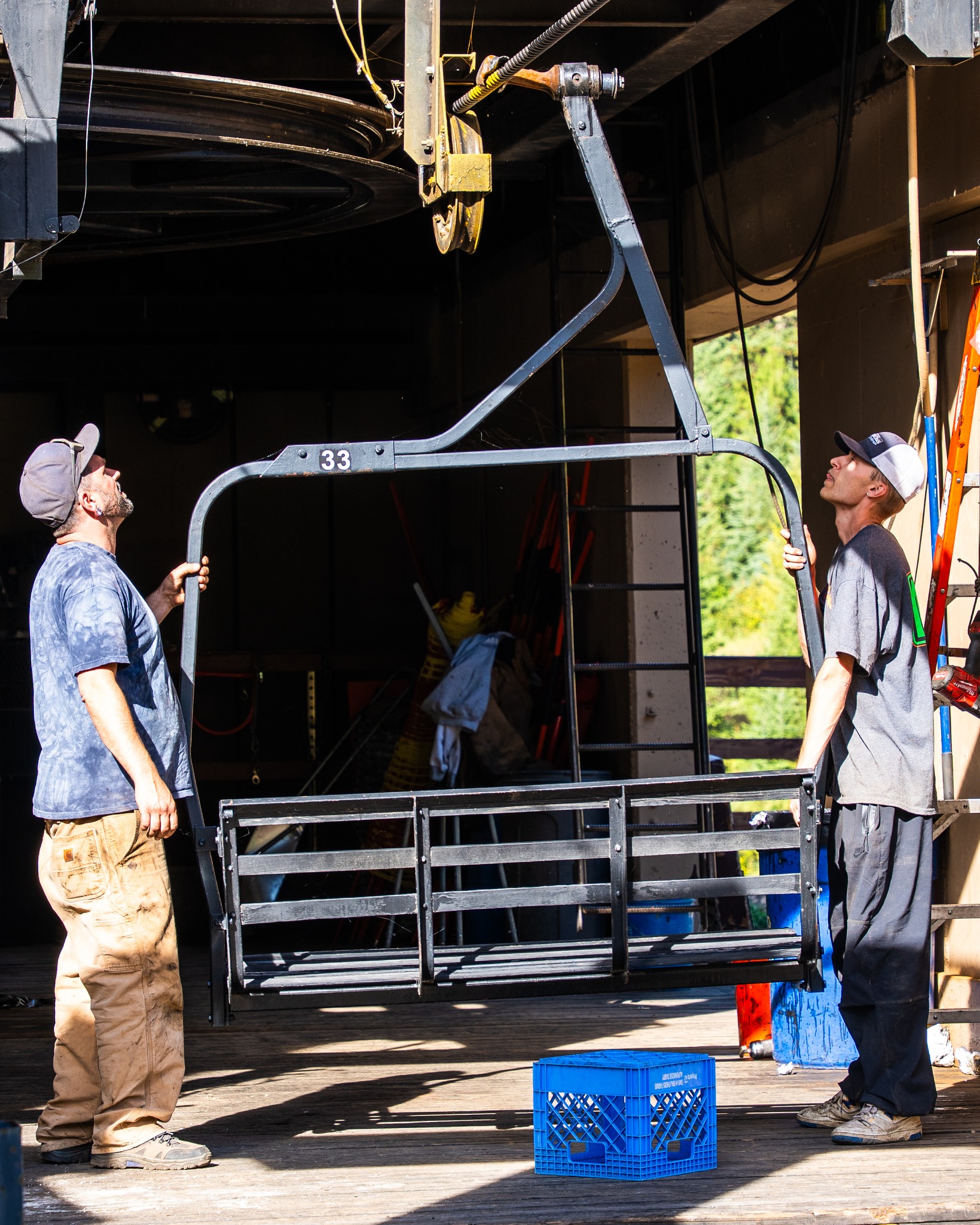

Bluewood lift maintenance staff re-hang chairs on the Skyline Express, a Borvig triple once scheduled to be replaced by a used detachable quad this year. Photo credit: Ski Bluewood

British Columbia-based Steelhead Systems Inc. (SSI) has responded to a lawsuit filed by Ski Bluewood, Washington over a delayed lift project. As I detailed last month, the two parties initially agreed to bring a used detachable quad to Bluewood in June 2024. The 1993 Doppelmayr lift would replace a base-to-summit triple chair and dramatically reduce ride time. SSI would act as a broker between Pro-Alpin Ropeway Services of Austria and Bluewood, bringing the lift from Sölden to Washington at significant saving versus a new lift. SCJ Alliance would engineer the lift and Bluewood would complete much of the installation work itself. Bluewood announced in late June 2024 the lift was expected to open for the 2025-26 season.

The deal soured this summer when disagreements arose over shipping costs, timelines, the number of shipping containers needed, exchange rates and more. In its claim filed in the Supreme Court of British Columbia, Bluewood alleged breach of contract, negligent misrepresentation and unjust enrichment by SSI. In its Response to Civil Claim, SSI’s attorney denies many of Bluewood’s claims, including that shipping costs and exchange rates were fixed upon contract signing. SSI alleges only after Bluewood stopped making payments did it stop shipping containers across the Atlantic. “Pursuant to [the agreement], all responsibility and risk with respect to the equipment, including transportation, rests with the Buyer,” the filing notes. “This responsibility includes any changes to shipping costs or exchange rates, which are matters outside the control of the Defendants.” SSI argues three outstanding invoices total $587,548.

SSI also alleges its principal, Zrinko Amerl, told Bluewood in 2024 that fall 2025 completion was an optimistic timeline. The complaint alleges Bluewood failed to provide accurate survey data in a timely manner. Steelhead Systems says SCJ Alliance’s engineer requested a 16th tower, which SSI agreed to provide at below market price. Finally, SSI alleges “ProAlpin insisted that there be a garage system put in place for maintenance and storage of chairs, however [Bluewood] refused to follow this recommendation.” On October 26th, I received word that SCJ did not request a 16th tower and that line was in the process of being corrected in the Response to Civil Claim.

To date 23 containers have been delivered to Bluewood containing chairs, terminal elements and towers. Four containers’ worth of equipment remains in Austria. Alarmingly, Pro-Alpin indicated to SSI that all remaining parts, including bullwheels and the haul rope, not picked up by September 8th, 2025 would be scrapped. “As of today’s date, SSI is unaware if any action has been taken with respect to this,” the filing notes.

Shortly after filing the response, SSI countersued Bluewood’s owners, alleging the lawsuit, associated press release and media coverage have damaged its reputation. The filing specifically mentions Lift Blog’s coverage and reader comments impacting SSI’s ability to sell lifts within the broader mountain resort industry. “As a result of the defamatory statements made by [Bluewood], SSI has suffered and continues to suffer losses to its business,” the suit says, alleging statements made by Bluewood will cause an estimated loss of approximately $10 to $15 million in revenue. The company seeks payment of outstanding invoices plus interest, damages and other costs.

Bluewood officials declined to comment beyond their initial press release, citing pending litigation. The ski area has been busy re-hanging chairs on the Skyline Express, the 1978 Borvig once set to be replaced.

News Roundup: Chairlift Ban

Killington to Replace Snowdon Triple

Killington Resort’s new, independent owners plan to spend $22 million on improvements next year, including construction of a new chairlift. Projects will include the fixed grip quad replacing the Snowdon triple, a lodge expansion, $2 million in snowmaking improvements and $2 million for new snowcats. The news comes at the end of a $38 million summer with Killington replacing the Superstar Express, installing new cabins on the Skyeship Gondola and rebuilding Skyeship’s cabin parking facility this offseason. By this time next year, The Beast’s new owners will have invested $60 million since purchasing Killington and Pico from Powdr in 2024.

The $6.5 million Snowdon Quad will load in a slightly different spot but follow roughly the same line as the outgoing triple, a Heron-Poma dating back to 1973. “The lift will feature fixed-grip chairs as opposed to detachable ones to help it stay operational during tougher weather events,” Killington noted. “This is part of a long-term strategy to maintain our network of fixed-grip lifts, ensuring reliable lift access to all areas of the mountain, even during inclement New England weather.” From the top of Snowdon, guests can access both the North Ridge Quad and Canyon Quad even if the nearby K-1 Gondola and Snowdon Six Express are closed. A manufacturer for the new lift was not announced though Doppelmayr built the new Superstar six pack this summer. Otherwise Killington operates an extensive fleet of Leitner-Poma equipment.

New Sigma Diamond cabins for the Skyeship Gondola awaiting installation.

Construction will begin in the spring and the Snowdon Quad is expected to open for the 2026-2027 ski season.

News Roundup: Upset

Caberfae Peaks Announces Green Mountain Expansion

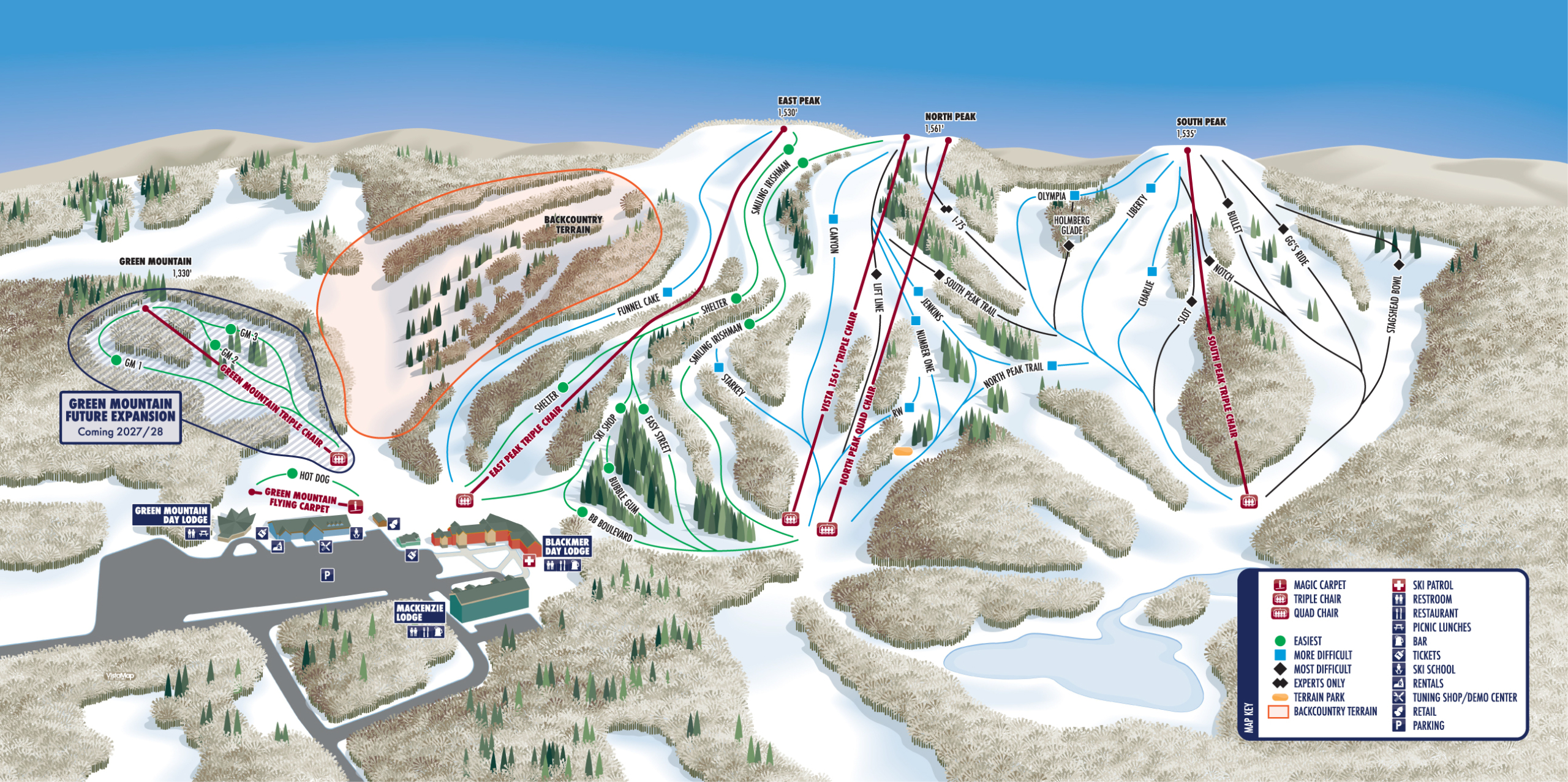

Caberfae, Michigan will build a Doppelmayr triple in 2027, servicing several new beginner trails on Green Mountain. The project follows construction of similar Doppelmayr triples on North Peak in 2016 and East Peak in 2022. This new lift will bridge a progression gap between the learning area and more difficult terrain on East Peak. “We are thrilled to begin this terrain expansion,” said mountain manager Pete Meyer. “Our skiers and riders will now have a dedicated, lift-served area to build confidence and skills before moving on to larger, more challenging slopes.”

Construction is already underway with planning, lift line clearing and grading completed in 2025, foundation and snowmaking installation planned for 2026 and steel erection following in 2027. The new terrain and Green Mountain Triple are expected to debut for the 2027-28 ski season.
